2022
Jan
Two-month food relief programme launched to feed 13,000 primary school children in the county of Marsabit, in the final term of the 21/22 Academic year.
Mar

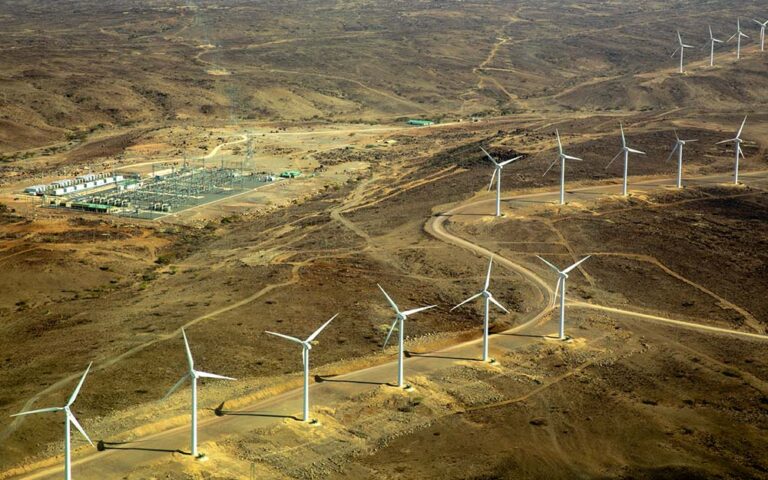

Three full years of uninterrupted operations
2021
Mar
100% Capacity Factor achieved. Full 310MW were generated.
2019
Jan

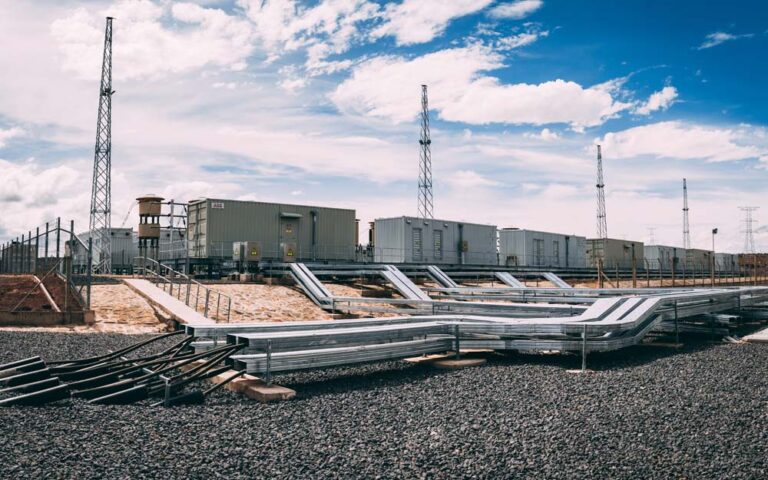

End of Hot Commissioning
Feb
Plant Commercial Operations Test (PCOT) complete
Mar
Full Commercial Operation
Jul
H.E President Uhuru Kenyatta Officially Inaugurates the Wind Farm
2018
Sep

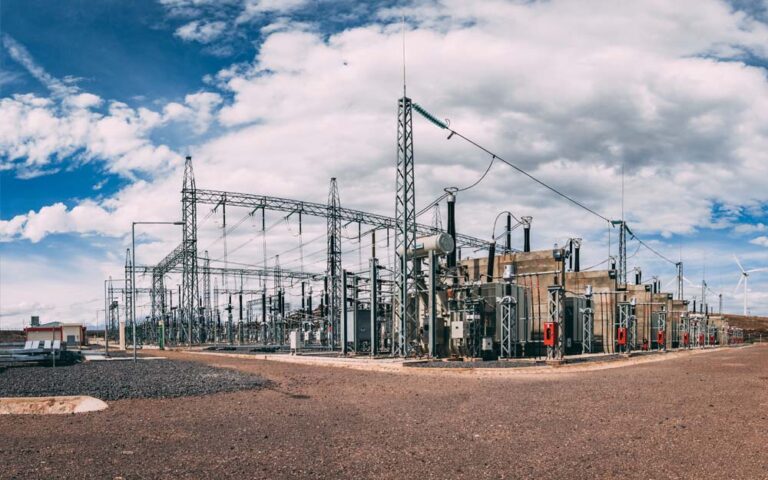

Transmission Interconnector Construction Completed and LTWP Energised / Operational (i.e. producing electricity)
2017
Jan

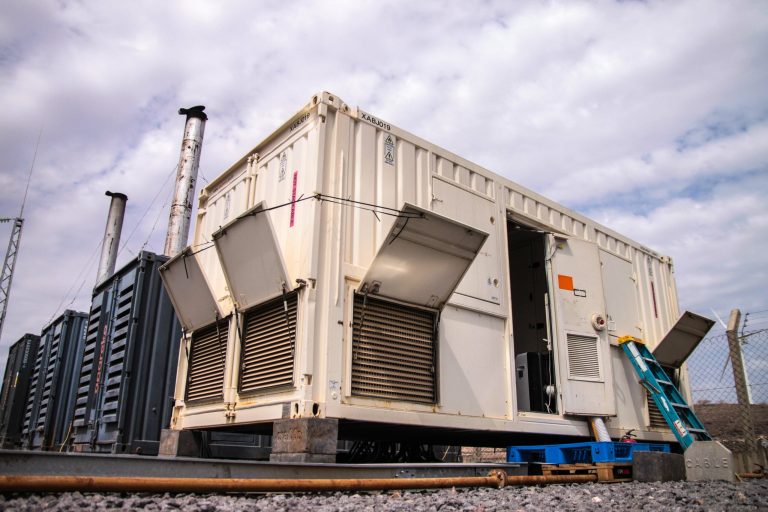

First Commercial Operations (Cold Commissioning)
Mar

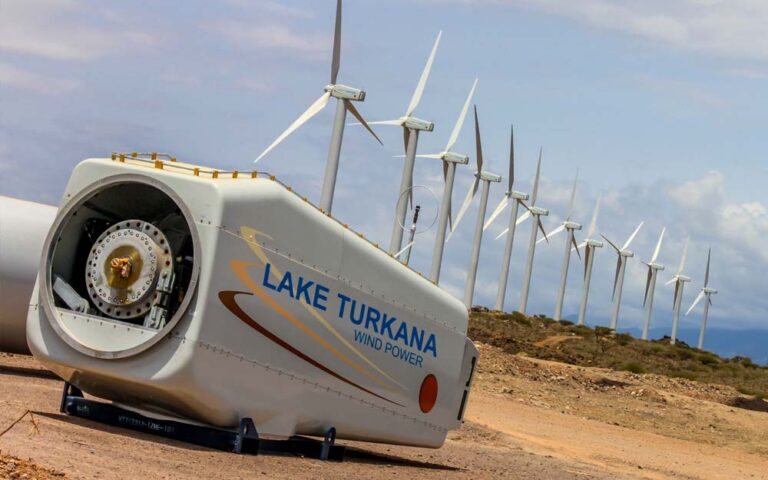

The last turbine installed
Apr

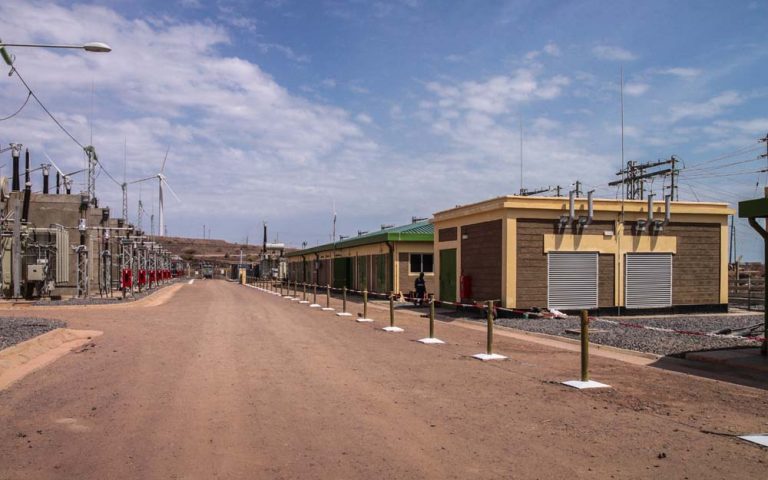

Completion of LOT 1
Jul

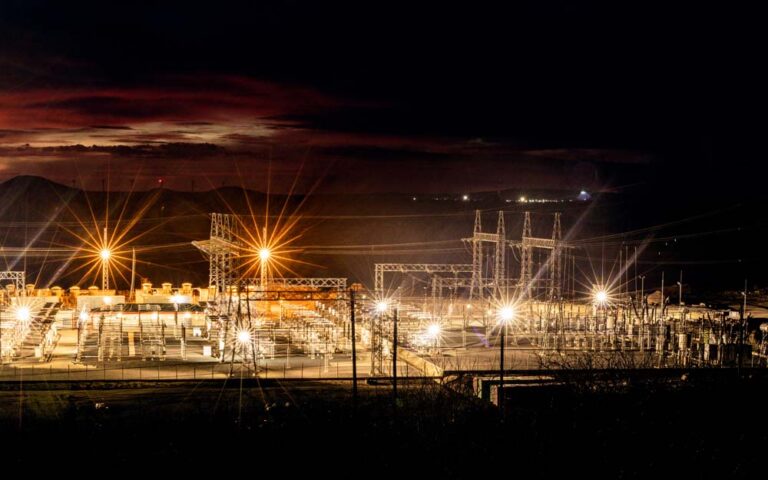

310MW capacity ready for full commercial operations
2016
Feb

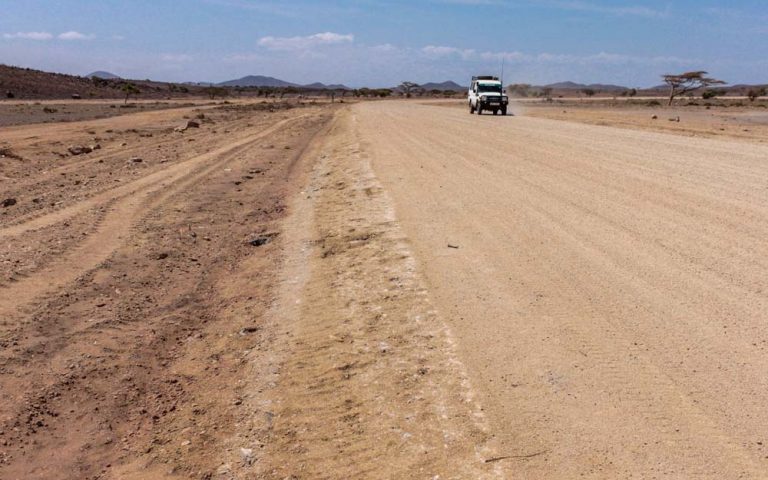

208KM of off-site roads from Laisamis to Sarima completed
Feb

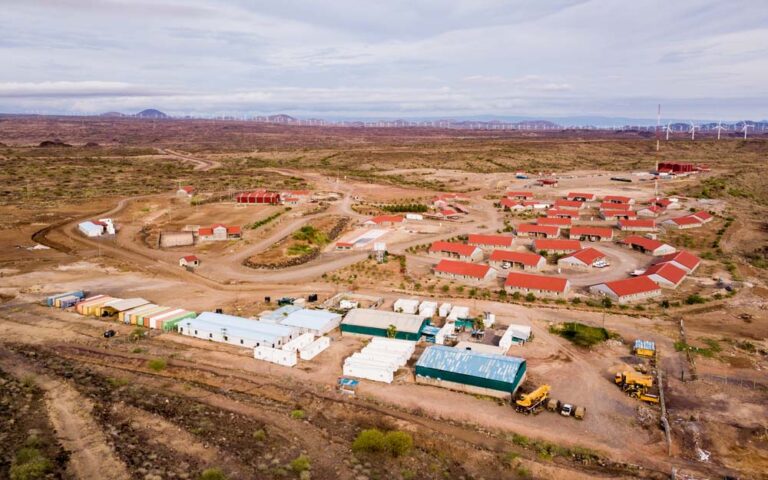

Project site village, offices and workshops completed
Mar

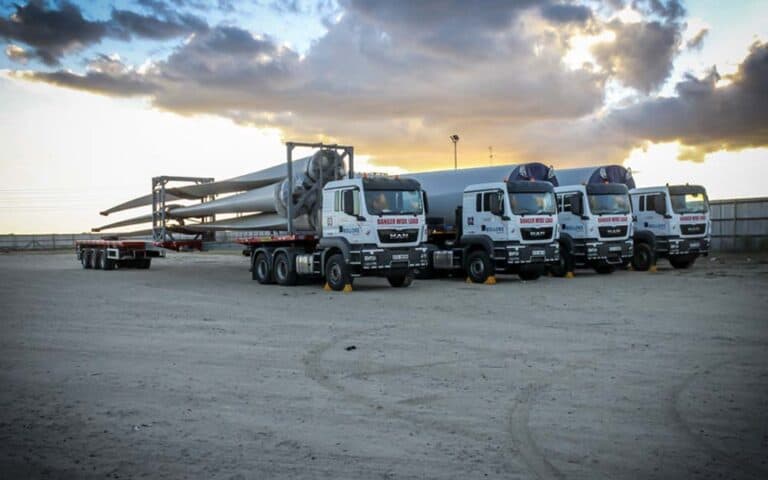

First turbine delivered and installed
Apr

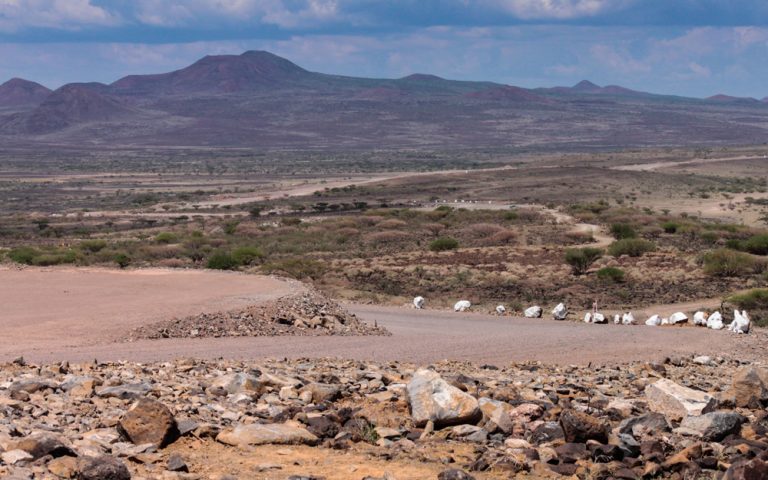

130KM of on-site roads completed
Sep

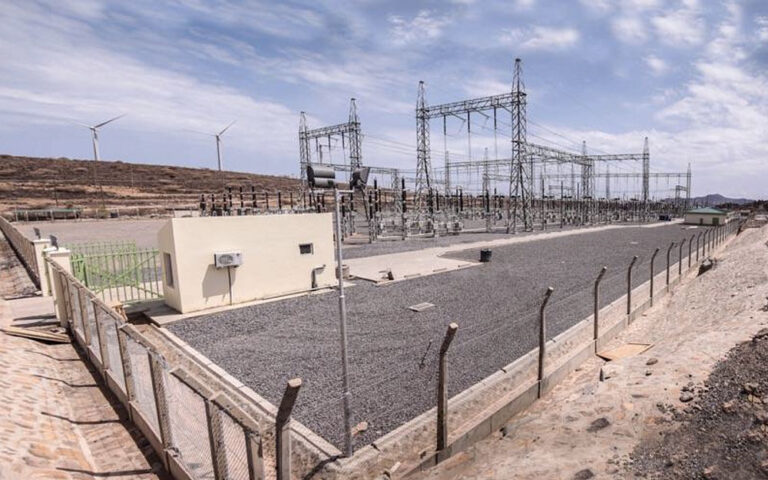

LOT 1 comprising 33kV overhead electrical collection network and 33/400kV (initially operated at 220kV) high voltage (HV switchyard) first section constructed, and Take-Over Certificate (TOC) issued
Oct

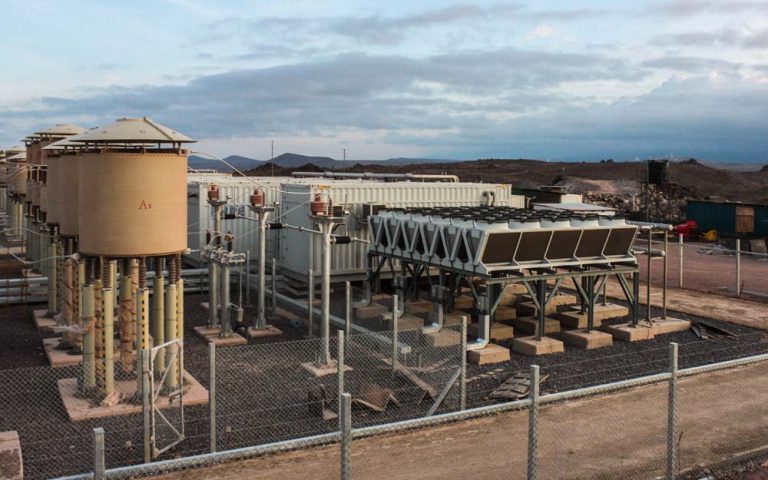

Provisional completion and installation of three dynamic reactive power compensation systems
Oct

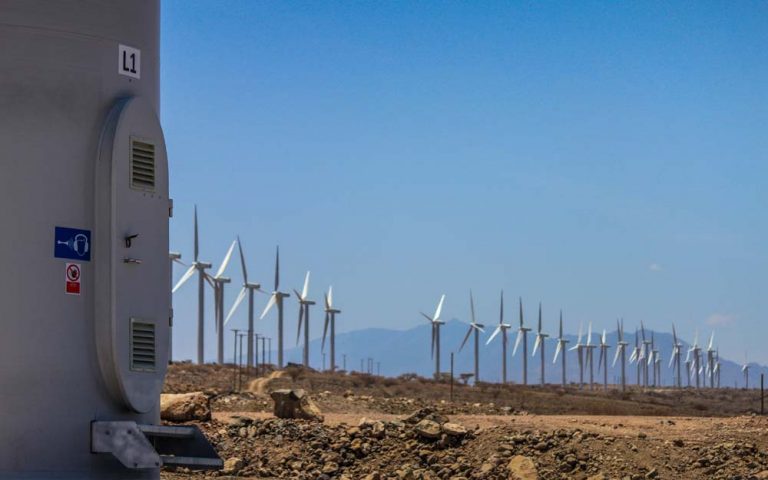

The first section (50-70MW) of the total 310MW capacity ready for commissioning
2015
Jul
Groundbreaking by President Kenyatta
2014
Oct

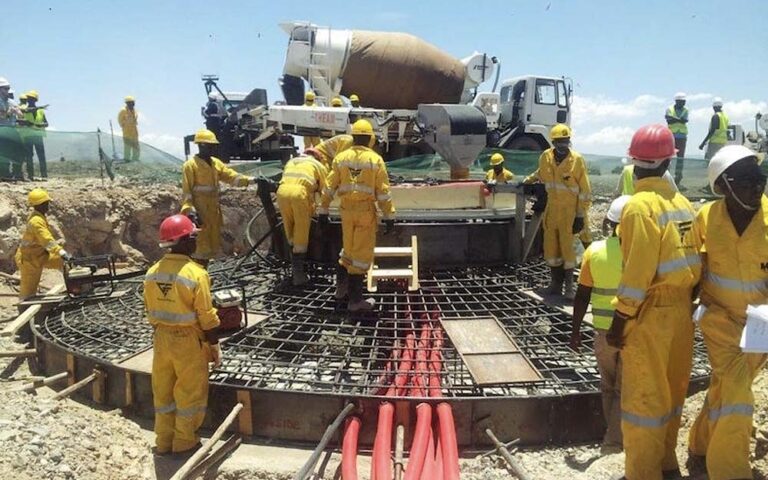

Construction Commenced
2005
Jan
